Your Bond at Work!
Explore Liberty Hill ISD's Bond@Work initiative, showcasing the impactful utilization of bond dollars. Witness the tangible improvements and enhancements across our schools - from state-of-the-art facilities to innovative educational resources. Discover how your support fuels progress and shapes the future of education within our community.
Liberty Hill Independent School District demonstrates an unwavering commitment to stewarding tax funds effectively through its groundbreaking Bond @ Work program.
By strategically allocating resources, the district optimizes every dollar invested, ensuring taxpayer money is utilized efficiently to bolster educational facilities, innovate learning environments, and cultivate a future-focused educational landscape.
The district's diligent approach reflects a steadfast dedication to maximizing community resources while delivering top-tier educational opportunities for its students and faculty.
Project Details by Location- Bond 2021 and 2023 Dollars
-
Safety & Security

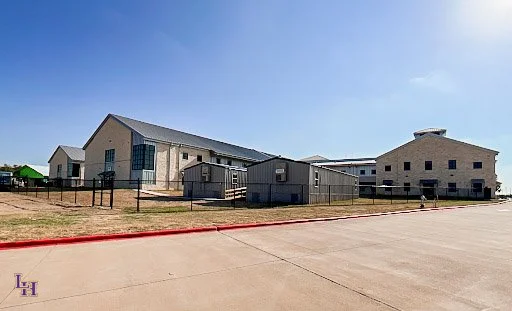

Fencing and gate installation around portables at multiple campuses – Complete
Cameras and radios installed at all campuses – Complete
Re-keying of all buildings – Complete
Bus Acquisitions (Transportation)
A total of 33 new buses have been purchased, with an estimated 5 buses to be purchased.
Technology Upgrades
New student and staff devices for growth and refresh
New server / storage platform
Refreshed device charging carts, new devices for CTE
New classroom TV's and carts
New projectors for SPED classrooms
New network cabling and switches, and wireless access points
Security Upgrades
Land Acquisition
Over 450 acres have been purchased, donated or being negotiated for new campuses
Renovations
Technology building renovation- Complete
Existing transportation facility improvements- Complete
New transportation facility construction to begin in September 2026
The 18+ facility renovation project- Complete
LHISD Police Department and Operations Center purchased with renovations to begin in early 2026
LHISD Agriculture Facility- Complete
Fencing, access controls and cameras added
Constructed awning for trailer and equipment storage and pen spaces
Renovated existing barns
-
Construction is 80% complete
Project scheduled to be occupied in August 2026
Design- Complete
Water, wastewater, and electric services- Complete
Baseball and softball fields- Complete
Tennis courts- Complete
Remaining athletic facilities- In Progress
-

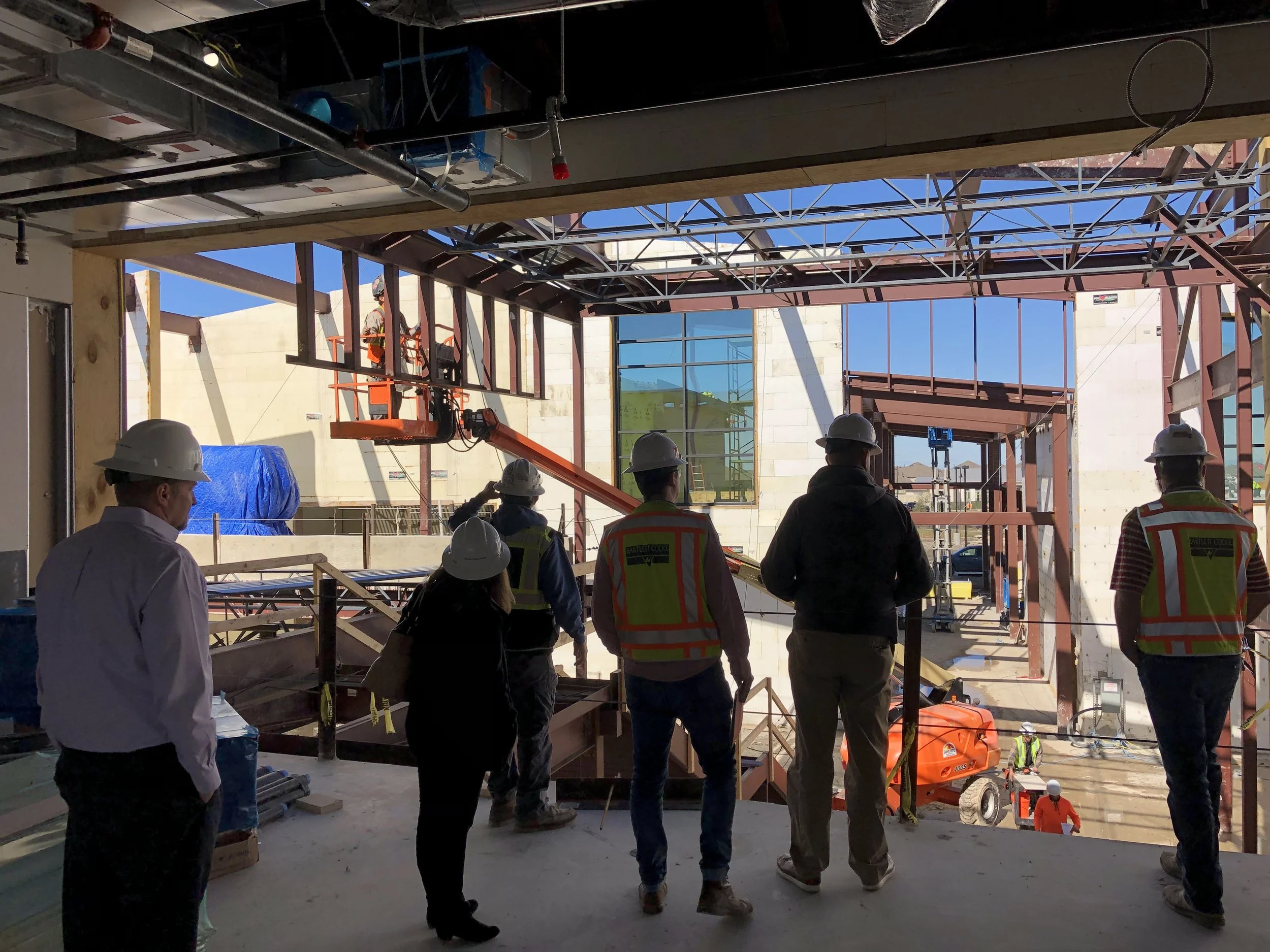

Construction of new band hall / CTE – In progress
Expansion to cafeteria – In progress
Flooring replacement – Ongoing
Construction of new CTE building - Complete
Security upgrade / secured vestibules - Complete
Infrastructure for Success Academy and DAEP classrooms- Complete
New north side concessions and restrooms - Ongoing
Construction of four new tennis courts / resurface existing courts - Complete
Repurposing of spring fieldhouse concessions for additional locker room space - Complete
Weight room renovation & new equipment – Complete
Girls locker room renovation - Complete
Increase Panther Stadium capacity to approximately 9,800 seats – Complete
Expansions completed on both Home and Visitor sides – Complete
Expansion of locker rooms and new weight room – Complete
Replace all competition field turf and resurface track– Complete
New wrestling room- In progress
-
Completed and occupied in August 2024 as Legacy Ranch High School. Will open as Legacy Ranch Middle School in August 2026.
Ongoing projects encompass final – Complete
Utility connections – Complete
Commencement of landscaping – Complete
Finishes to the building envelope – Complete
Building interior finishes – Complete
MEP start-up and commissioning – Complete
Development / completion of competition track and field – Complete
-
Tech Building Remodel & CTE Classroom Conversion– Complete
New classroom additions – Complete
Cafeteria expansion – Complete
New Administration offices – Complete
New science laboratories – Complete
New equitable turf, press boxes, track and field and concessions – Complete
Fine Arts Wing refurbishing – Complete
Fire sprinkler system/HVAC/Roofing – Complete
Library renovation – Complete
-
Construction of 10 additional classrooms – Complete
Turf, press boxes, track and field and concessions – Complete
-

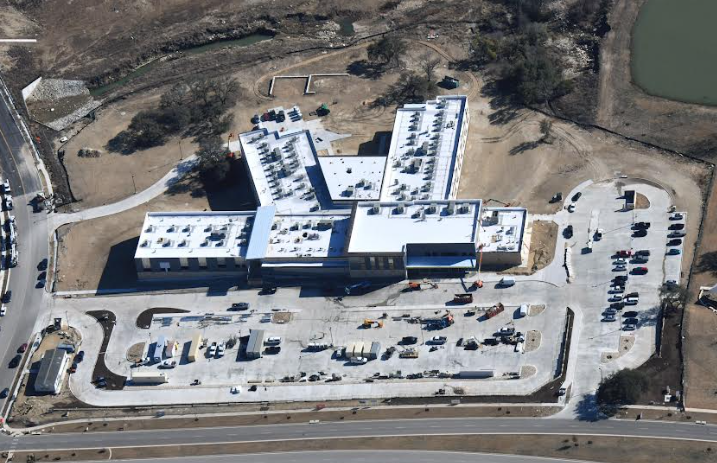

Campus opened and occupied in August 2023 with closeout and warranty – Complete
Partnered with WILCO and City of Leander for a new traffic light at Bar W and Rancho Sienna Blvd – In Progress
Developers have paved Stamp Iron around Bar W making the bus drive accessible – Complete
Saddle Tree Pass completed to provide access to school from Kaufmann Loop – Complete
-
Safety and Security Upgrades - fencing and security film, constructed secure vestibule – Complete
Carpet replaced- Complete
Upgrade playground equipment and walking track – Complete

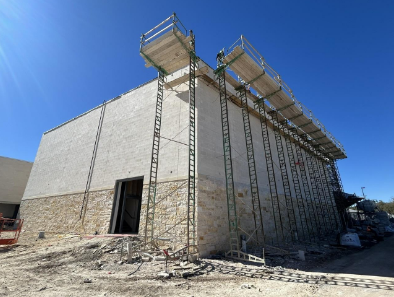

Add classrooms to raise capacity to 1,000 students- Scheduled to open in August 2027
-
Construction 45% complete
Scheduled to open August 2026 with a capacity of 1,000 students
Tilt wall and structural steel erection – In process
Roofing, Framing and Decking- In process
Design – Complete
Major earthwork and utilities – Complete
Concrete foundation and tilt walls – Complete
-
Interior work at administration – Complete
New front entrance with secure vestibules- Complete
Gym expansion – Complete
Additional equity items – Complete
Construction of new classrooms – Complete
Exterior landscaping – Complete
Front parking area patched, crack sealed, seal coated, and striped – Complete
Re-roofing of existing classroom wing and administration – Complete
Concrete, fence, ramp and basketball goals- Complete
-
Interior work at Administration with secure vestibule – Complete
Library reconfigured into SPED and offices, and existing classroom spaces repurposed – Complete
New library space – Complete
Classroom additions – Complete
Additional equity items – Complete
New fencing for backyard space – Complete
Move all portables – Complete
Create new playground space – Complete
-
Security upgrades - fencing and security film and constructed secure vestibule – Complete
Add turf fields in back playground – Complete
Add classrooms to raise capacity to 1,000 students- Scheduled to open in August 2027
-
Security Upgrades - Fencing and security film – Complete
Car rider drive extension – Complete
Move portables to LHHS – Complete
Add classrooms to raise capacity to 1,000 students- Scheduled to open in August 2027
-
Completed and occupied in August 2024
Gym acoustic wall panels installation – Complete
Basketball goals, toilet partitions and accessory installation – Complete
Installation of the gym floor, stage curtains in the cafeteria, ceiling tile and kitchen equipment – Complete
Final utility connections – Complete
Commencement of landscaping – Complete
Finishes to the building envelope – Complete
Building interior finishes – Complete
MEP start-up and commissioning – Complete
